Gas mains relocations
We may be able to relocate the main gas pipe in the street if your construction work comes close to it or if the gas main is in the way. Wherever you dig, ensure you request reference maps of our underground network at the free B4UDIG website.
If you need to relocate the gas service pipe on your property, please contact your gas retailer.
Explore this page:
Before you apply
Please have the following information ready:
- Location details (address, site plans)
- Billing details
- Site contacts
The process and timeframes:
The process and timeframes may vary depending on a number of factors, including:
- The conditions of the work site and the complexity of the job
- Whether the gas mains we need to relocate is made of steel
- Whether an easement is required to allow gas and electricity equipment owned by Vector to be installed and to remain on private property. An easement provides us with ongoing access and maintenance rights in respect of that equipment.
- When traffic management services are next available (as these are managed by third parties) and the availability of equipment required
- Whether we need to relocate a DRS (district regulator station)
- Other technical, legal, regulatory and administrative factors (including resource constraints)
Simple process of relocating gas mains | |
|---|---|
Initiate | Call 0800 22 22 60 to request a gas mains relocation. |
Quote & payment | We aim to provide a quote with our terms and conditions within 10 working days. You have 30 days to accept and sign our terms and conditions and pay the quote |
Build | Once payment and the quote acceptance has been received it generally takes 6-8 weeks to complete the job |
Complex process of relocating gas mains | |
|---|---|
Initiate | Call 0800 22 22 60 to request a gas main relocation. You’ll usually receive an estimate of the indicative cost of the works within 10 working days |
Design | You will need to pay for the design cost for the job to proceed . We will usually advise you within 1 week after payment when the design will be completed |
Contract and payment | Once we’ve received design approval, we will aim to send you a customer works agreement within 5 working days (that is valid for 45 days). We will then contact you to schedule the work once the agreement has been signed and payment received |
Build and variations | Work will usually begin approximately 6 weeks after receipt of payment |
Completion | We finish the work |
FAQs
Some of our natural gas network is made out of steel. To be able to disconnect your service from the steel network, we require specialised equipment and personnel.
Electricity and gas easements are important because they benefit both Vector and landowners by:
- Protecting a landowner’s safety by formally recording the location of the gas and/or electricity reticulation equipment on their property title.
- Providing us with legal rights to access your property so that we can operate, maintain or replace our equipment.
Easements are required over installed Vector owned gas and electricity equipment to allow those assets to remain on private property and to provide us with ongoing access rights.
Vector owned equipment means equipment installed by us as part of our work supplying customers with electricity or gas. This can include pits, poles, lines, cables, fuses and transformers, gas pipes, gas measurement systems, distribution systems and fittings, and other associated equipment.
Private property means real property that is privately owned and includes privately and jointly owned access roads in subdivisions, Council local purpose reserve or recreation land and Crown land.
Equipment installed on private property before 1 January 1993
For electricity and gas equipment installed on private property prior to 1 January 1993, we have existing use rights (which is a statutory right contained in the Electricity Act 1992) and will not usually require an easement unless we need to install new equipment or relocate existing equipment.
If new equipment is to be installed, we will require an easement over all new equipment together with any existing equipment as it may no longer be protected under the pre-existing statutory use rights.
We will let you know when an easement is required, and whether this is for new or existing electricity equipment. Where an easement is required, the obligation to grant an easement will form part of your contract with us to undertake the works.
We have standard easement terms which grant us necessary rights to access your property to inspect, operate and maintain our equipment. These must remain standard and unamended, for all properties throughout Auckland, so that our contractors and maintenance team can rely on them.
To register an easement, following installation of equipment, either we or the customer will organise a survey plan (depending on our contract together) which shows the area that will be granted to Vector for our easement. A legal document called the ‘easement instrument’ is then prepared by our legal team and sent to your solicitor. The registration of the easement on your property title will be processed by us together with your lawyer.
Vector owns the gas service pipe up to and including the gas riser (pipe going to the gas meter). The meter company owns the gas meter. You will own all outlet pipes from the gas meter to the appliances.
No.

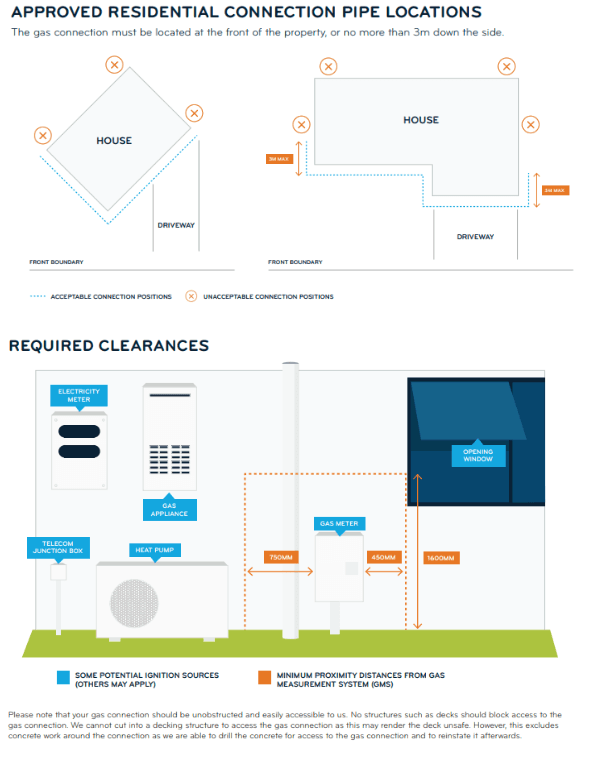

Residential gas connections must be installed in certain areas and must have clearances away from sources of ignition such as electricity meters and meter boxes as well as building openings such as doors, windows and flue terminals. For further information regarding approved pipe locations and meter clearances refer to the drawings below or talk to your energy retailer.
Commercial gas connections are generally placed on the boundary of the site. For safety reasons all public areas such schools, hospitals and parks will require a gas connection to be placed on a concrete pad and within a cage. If there is a lot of vehicle traffic, an additional barrier may also be required. Your energy retailer will be notified by the meter owner if a concrete pad and cage is required and they can also provide any further information regarding meter positions and clearances.
